Maps
Where each site is, and how big, on maps drawn from official boundary data (Project Beehive's outline is traced approximately from NPR's map).
Every outline except Project Beehive's, which is traced approximately from NPR's map, is drawn from official boundary data: the BLM survey grid, county parcel maps compiled by the state, and BLM's own case map. Those outlines are accurate to the tens of meters those datasets carry; they are not a legal survey. Basemap: USGS The National Map (public domain). Tap a map for full size.
Every project
DOE-authorized; reached zero-power criticality June 18, 2026; a DOE slide prepared for the NRC Commission's 21 July 2026 meeting lists full power, 100 kWt, on July 2, 2026 (the slide gives no data); its safety papers describe a 12-month test.
Emery County approved selling it to Valar for $394,500 (records disagree on whether the sale closed); Valar told the county it wants it for fuel fabrication and manufacturing; in July 2026 Orangeville was drafting a zone so the land could be annexed into the city, and its draft minutes of September 10, 2026 record that the annexation has been held up over mineral rights and that the city is waiting for the purchase to be finalized.
Lease approved Sept 17, 2026 for a nuclear, fuel and industrial campus, up to a century, with the right to buy; all required permits must come before any construction; no county permit application found in the planners' notices as of October 17, 2026.
A Notice of Location dated Sept 12 names Valar as locator; the county zoning map shows the land as rural residential, though about 37% of it is federal land, which Utah's county land-use law does not put under county jurisdiction; the deadlines are about Oct 12 for the county copy and Dec 11 for the BLM filing; no county recording of it was found in the records read, as of Oct 17, 2026.
Pending with BLM as of late September 2026; Valar told a reporter it applied for survey access and has decided not to pursue it.
A second pending BLM application by Valar for a reactor and data-center site; BLM's public records show no location for it.
Altigen JS, LLC's permit was on the Carbon County Planning Commission's October 6, 2026 agenda; the developer's stated plan is gas-fired power plants; no record read links it to Valar.
The maps

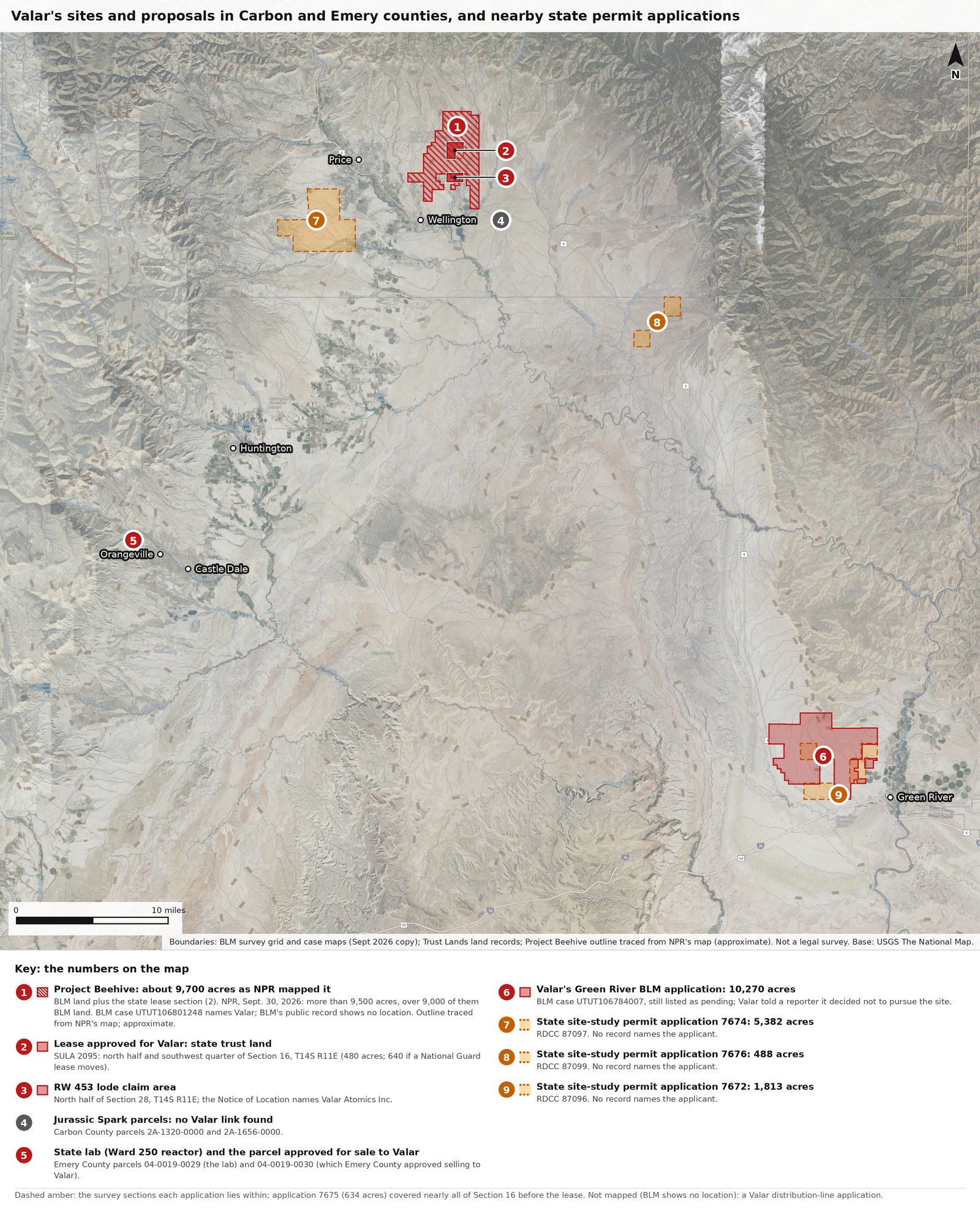

The region: Valar's sites and proposals in Carbon and Emery counties, Project Beehive, and nearby state permit applications

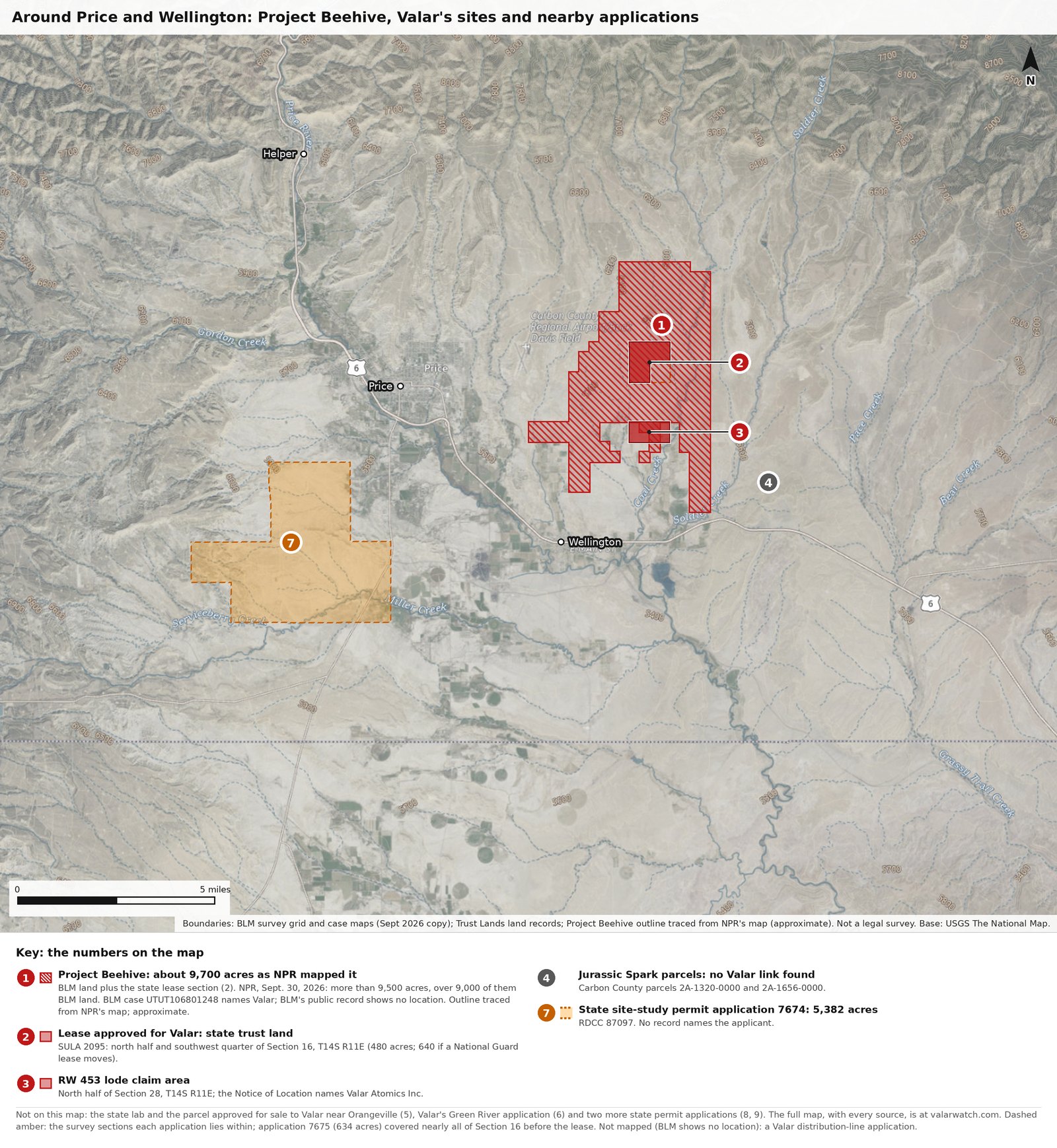

Around Price and Wellington: Project Beehive, Valar's sites and a nearby state permit application

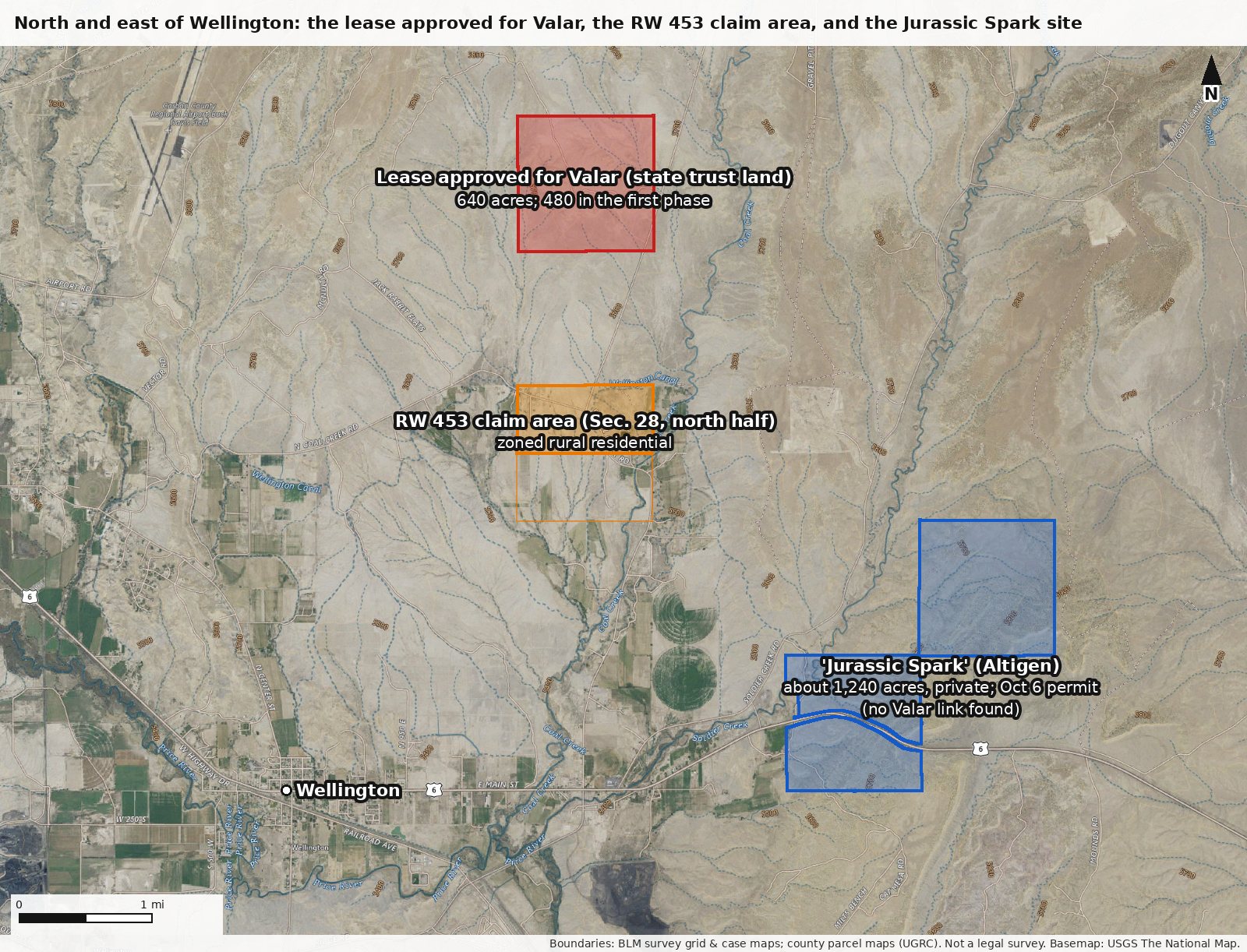

North and east of Wellington: the lease approved for Valar, the RW 453 claim area, and the Jurassic Spark site

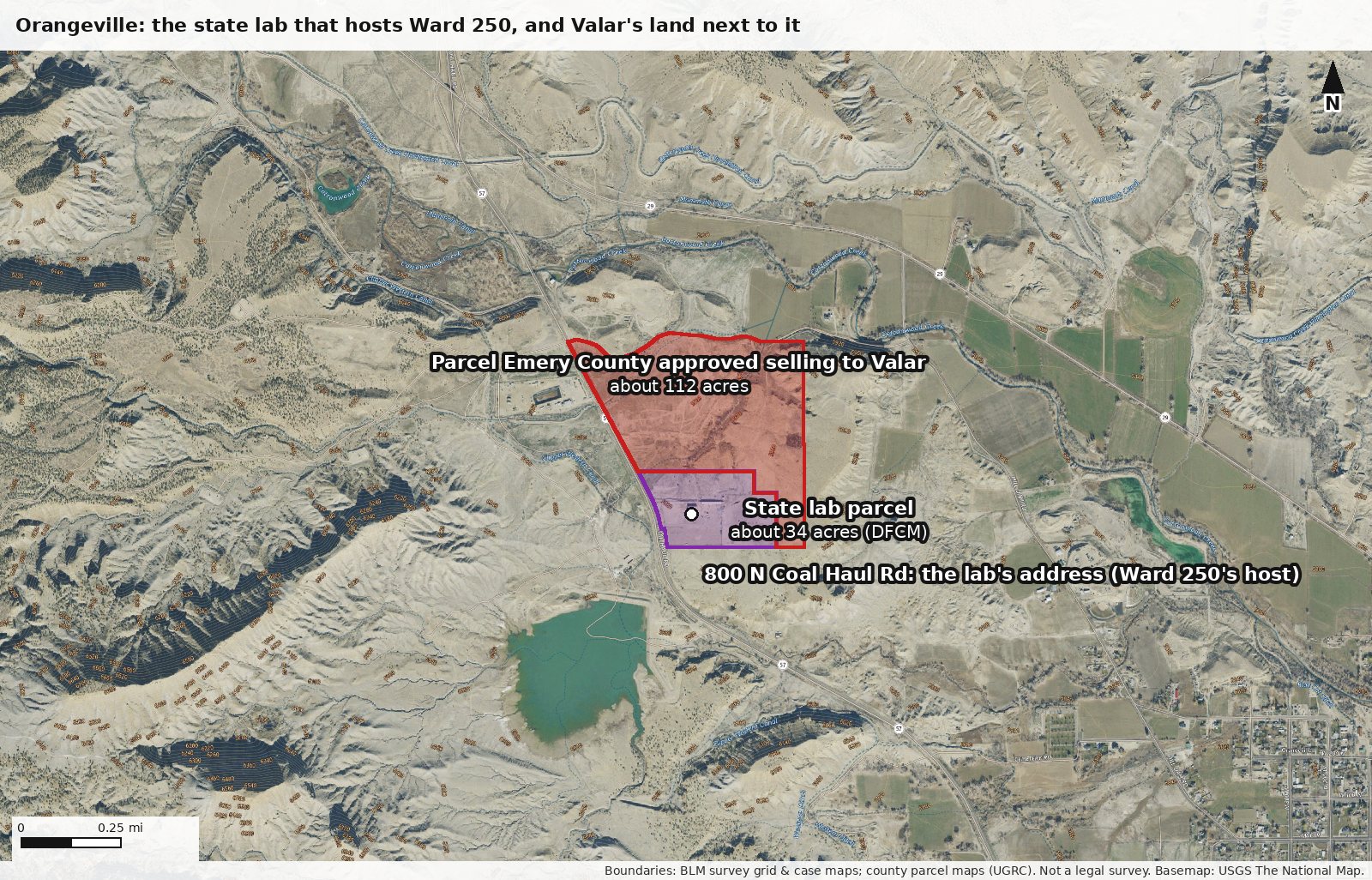

Orangeville: the state lab that hosts Ward 250, and the land next to it approved for sale to Valar

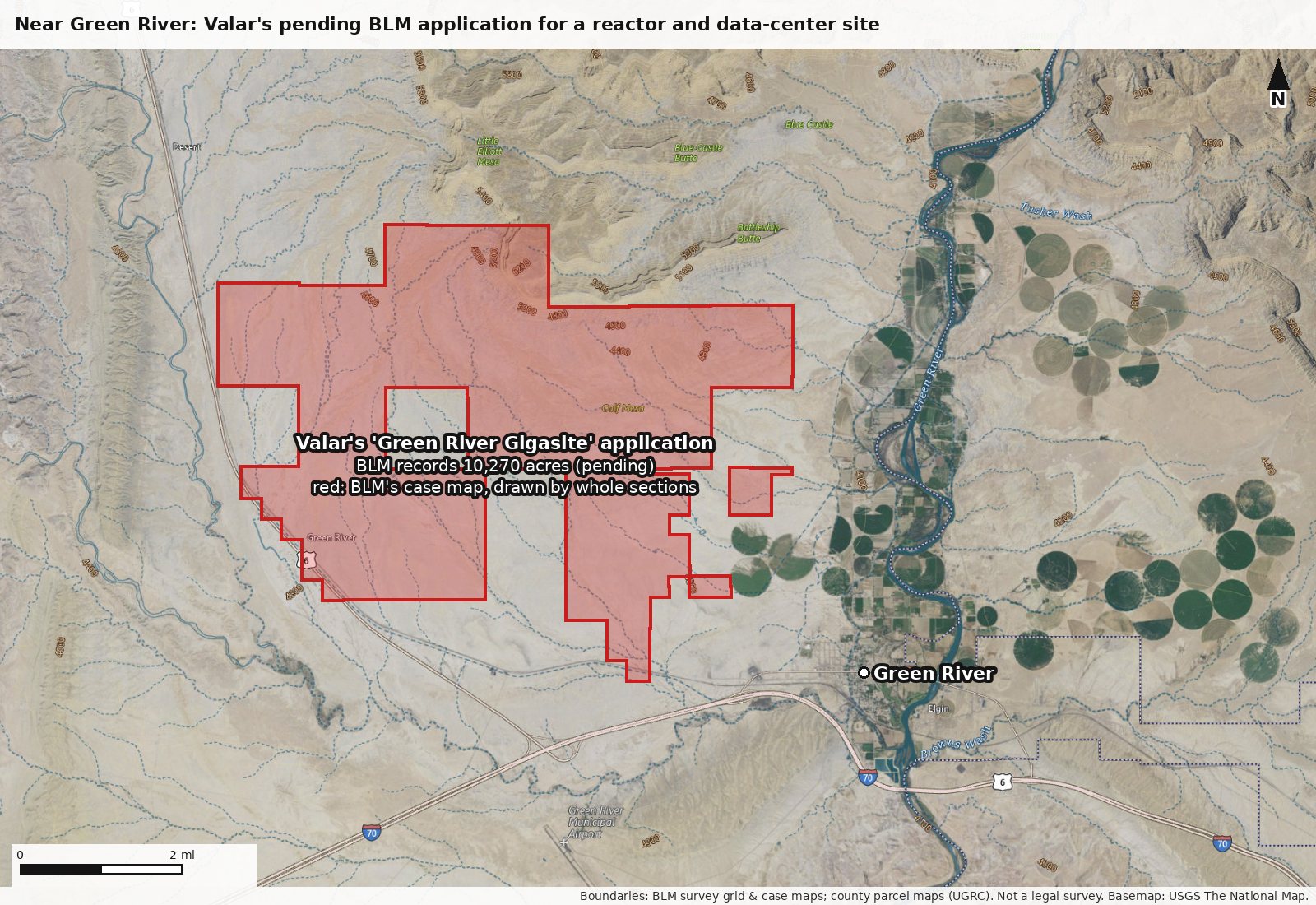

Near Green River: Valar's pending BLM application for a reactor and data-center site

'Jurassic Spark': the two parcels in Altigen's technology-park permit, east of Wellington
